PLAIO gives a contract manufacturer one schedule for every client's orders. Forecasts, firm POs, changeovers and the materials behind each batch are in it, so the dates you quote hold up.
All of a client's orders on one schedule
Firm orders from all your clients share the same lines. Each product still follows its own routing.

Your lines run products for many clients. Someone pulls an order forward. A forecast you planned around never turns into a PO. Packaging for another client turns up a week late. If the schedule lives in a spreadsheet, each of those means rebuilding the week by hand, and sooner or later a delivery date slips.

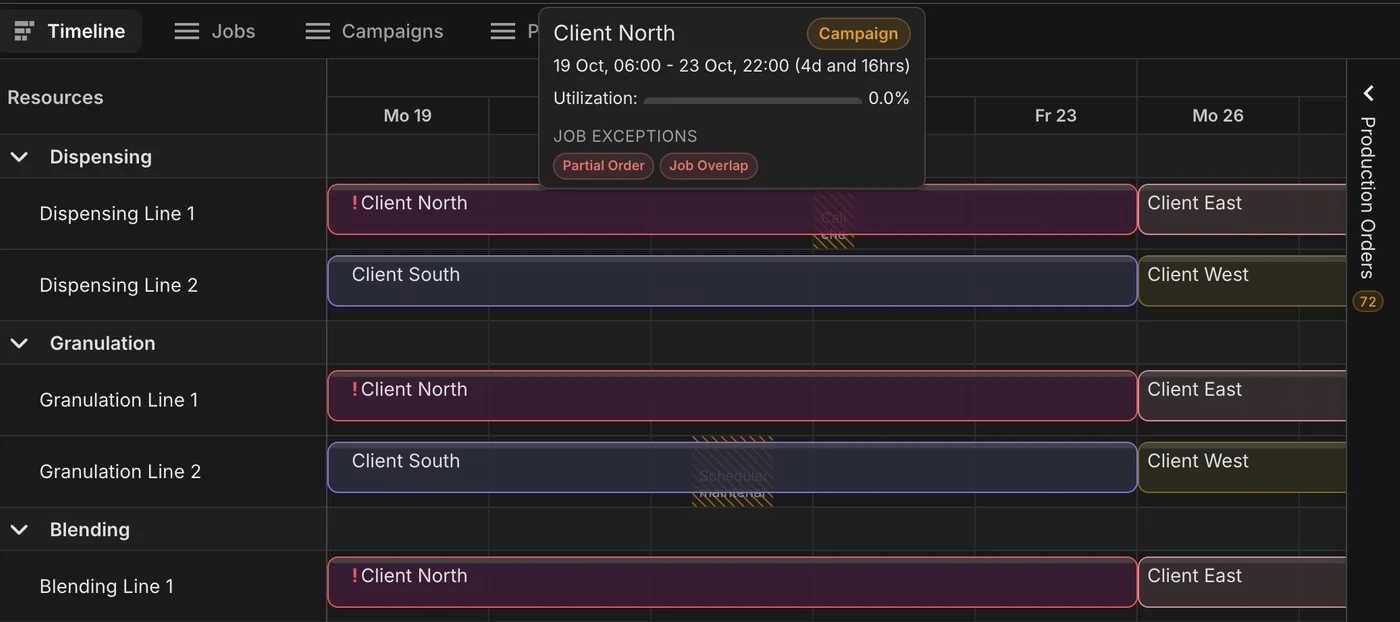

Put a tablet on the blender after a cream and you need changeover time. Granulation must start within a fixed window after dispensing. Clients compete for the same equipment, and switching between their products costs cleaning time.
PLAIO puts all client orders on one Gantt and checks each job against its routing and the line calendar. A job that won't fit gets flagged before anyone on the floor sees it.
Clients pay you to deliver on the date. Finding the conflict at your desk on Monday is far cheaper than hearing about it when they ask where their batch is.

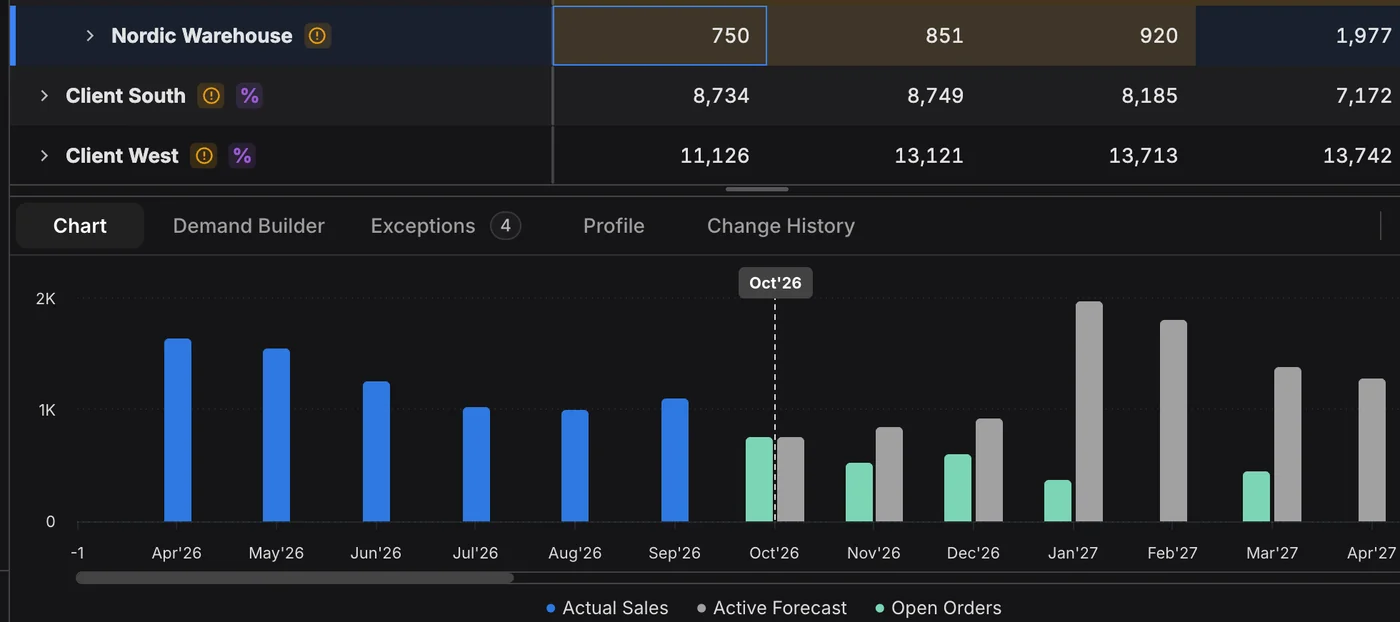

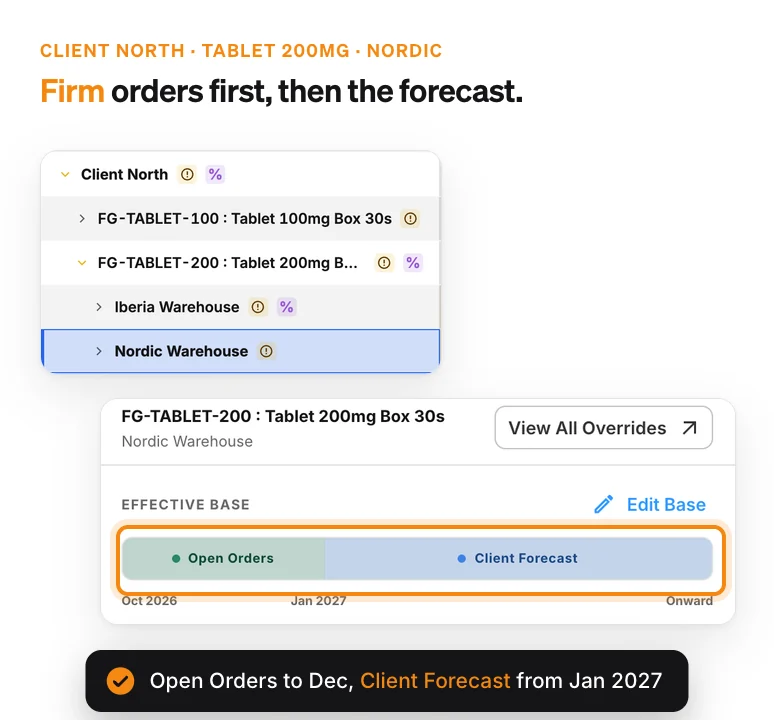

In the Demand Builder, open orders cover the months a client has confirmed and their forecast covers the rest. Group by the customer dimension to see how much of next quarter is already firm.

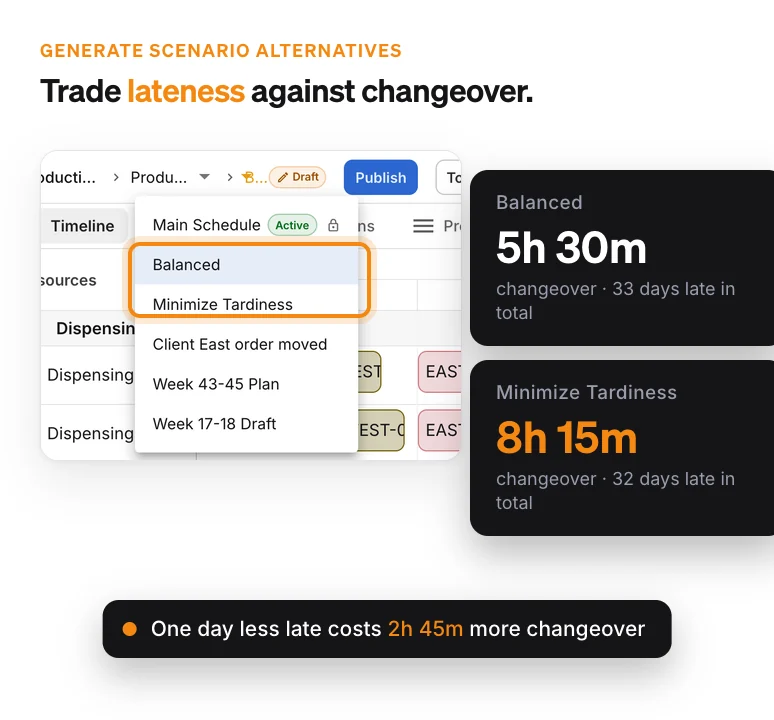

Changeover times depend on which product ran before, and you set them per line. PLAIO can generate schedule alternatives that weigh late orders against changeover time. Keep whichever suits the week.

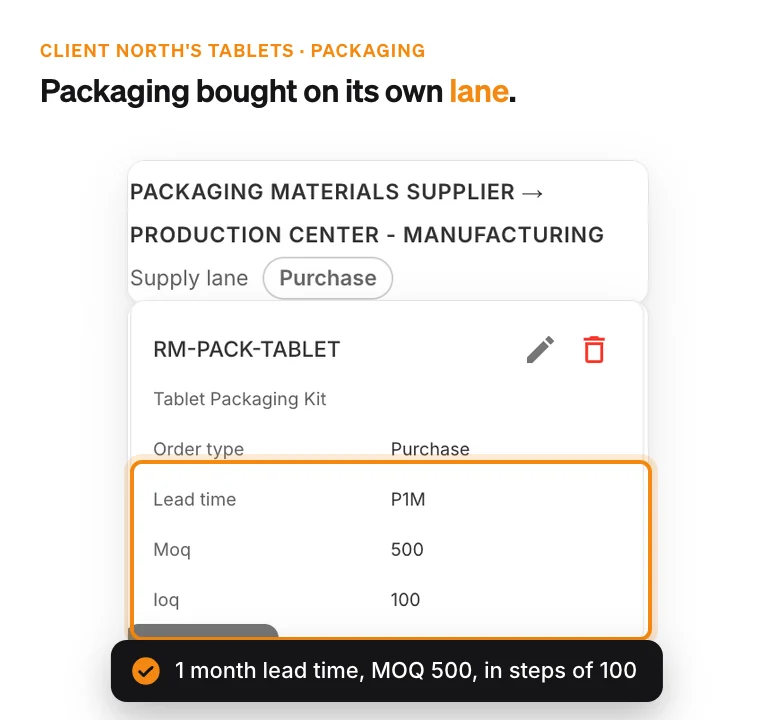

Components and packaging live in the product's bill of materials and are bought on supply lanes with their own lead times and MOQs. If the material won't arrive in time, the job is flagged.

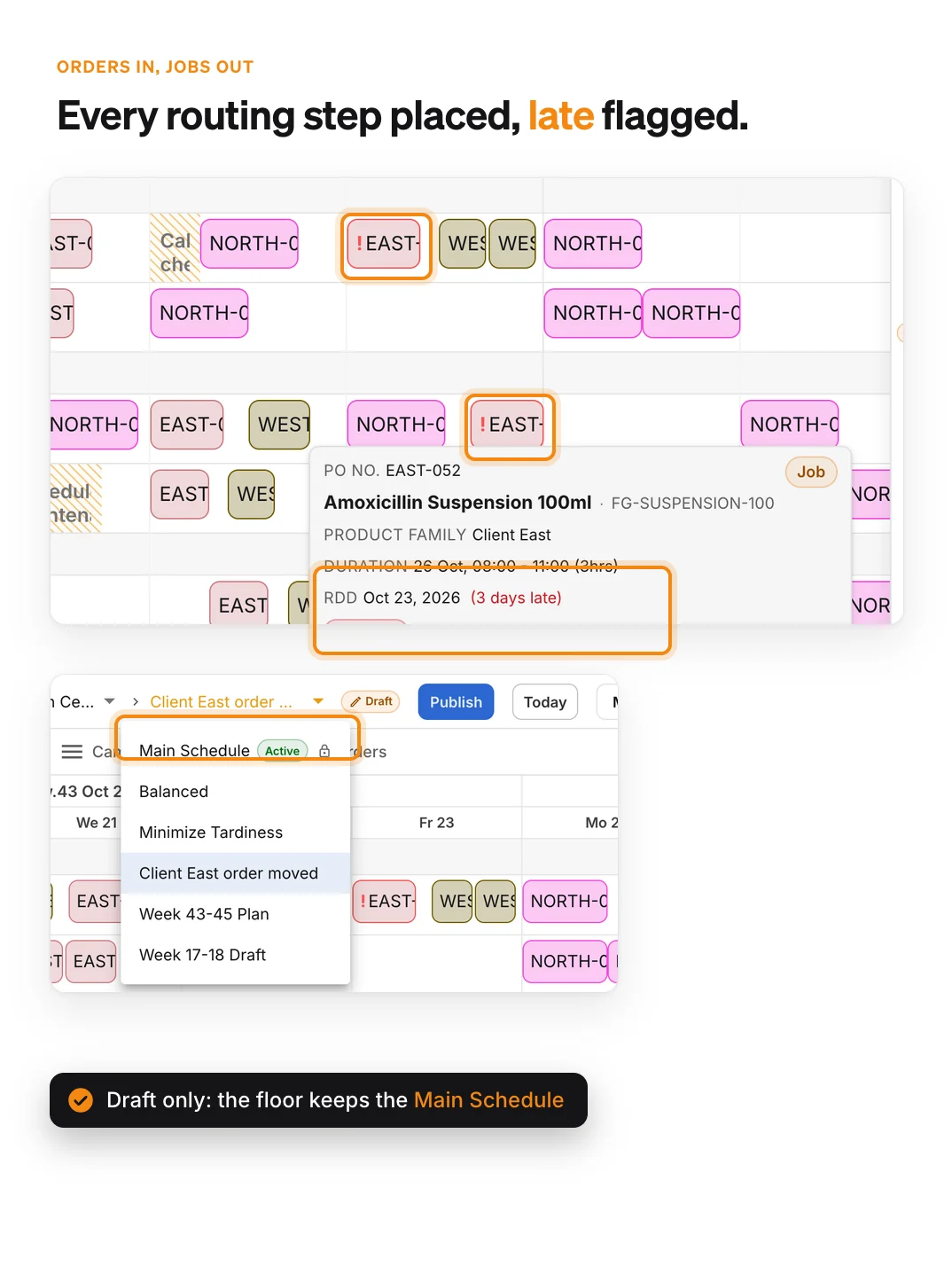

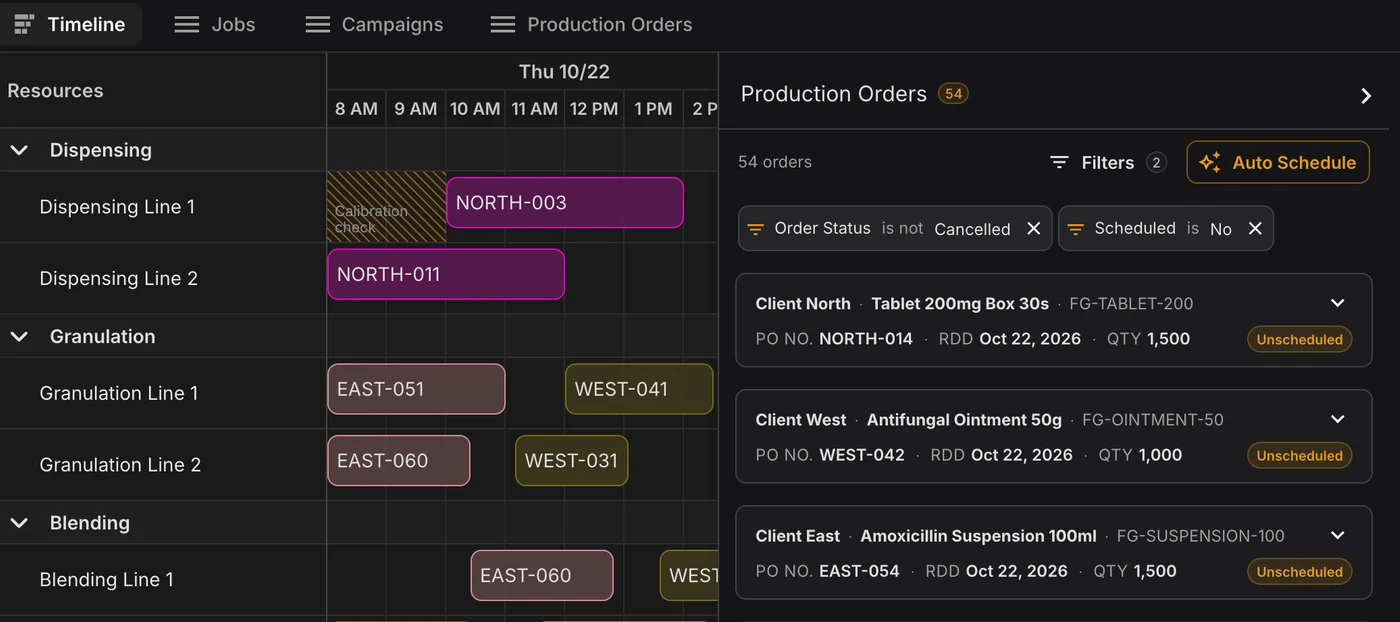

A production order has an item, a quantity and a delivery date. Schedule it and you get a job for each routing step, each on a named line. Auto Schedule fits the orders you pick around shifts and downtime.

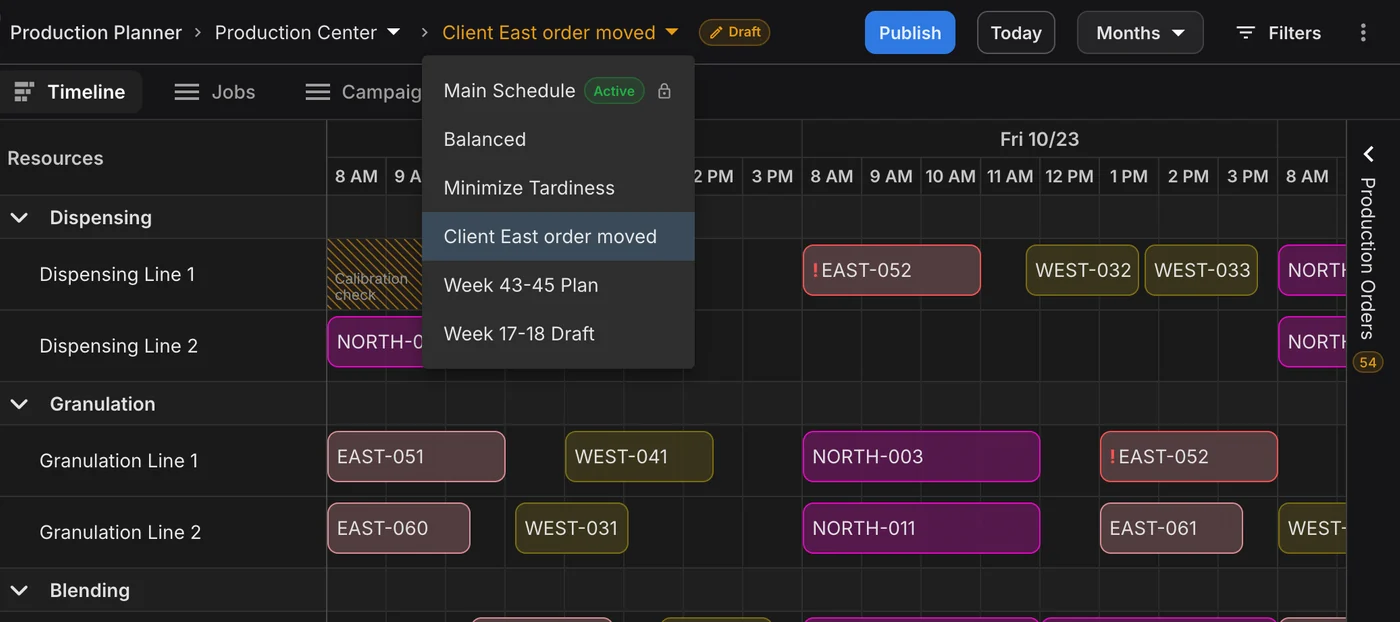

When a client moves an order you can drag the jobs, or try the new date in a draft next to the published schedule. The floor keeps reading the active schedule until you publish.

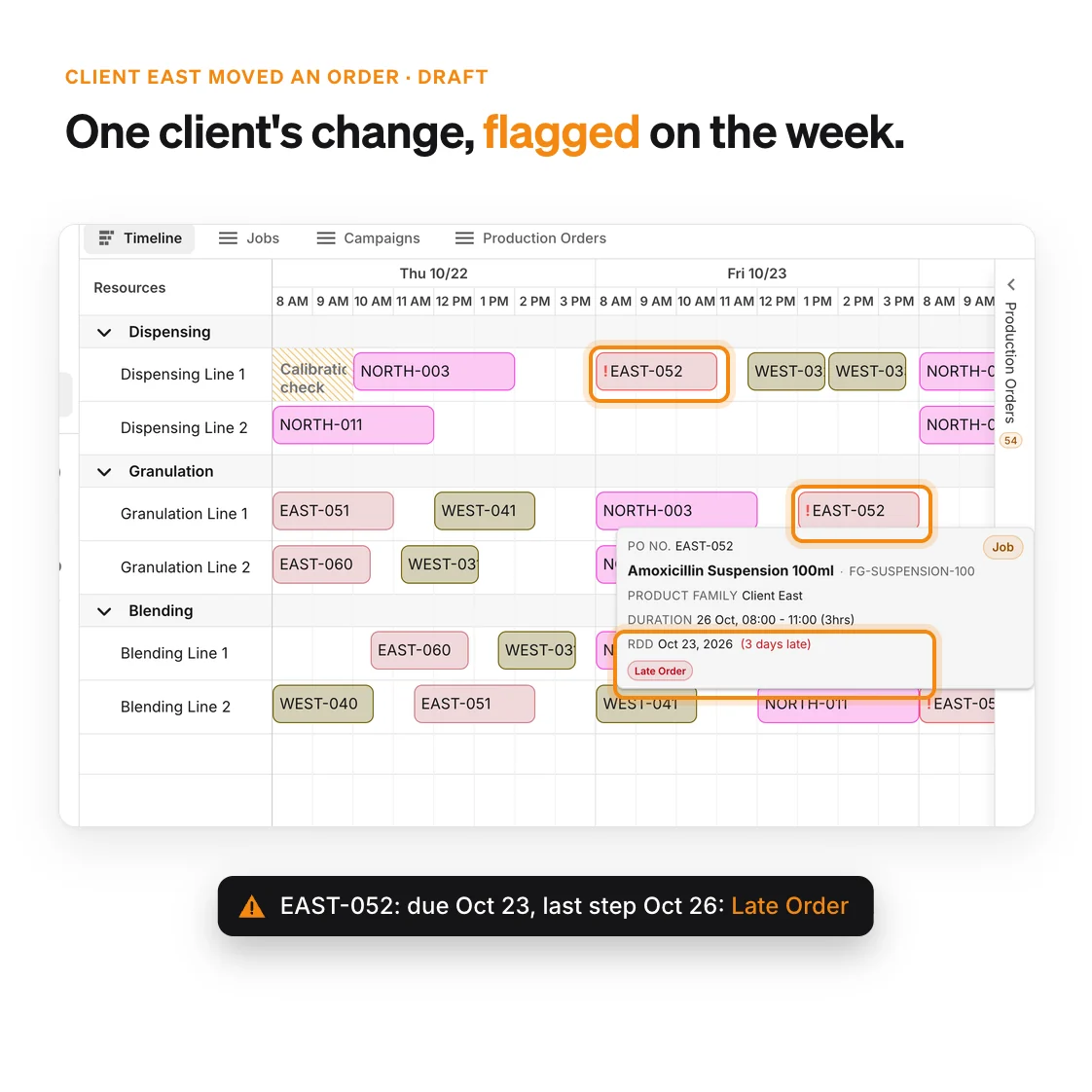

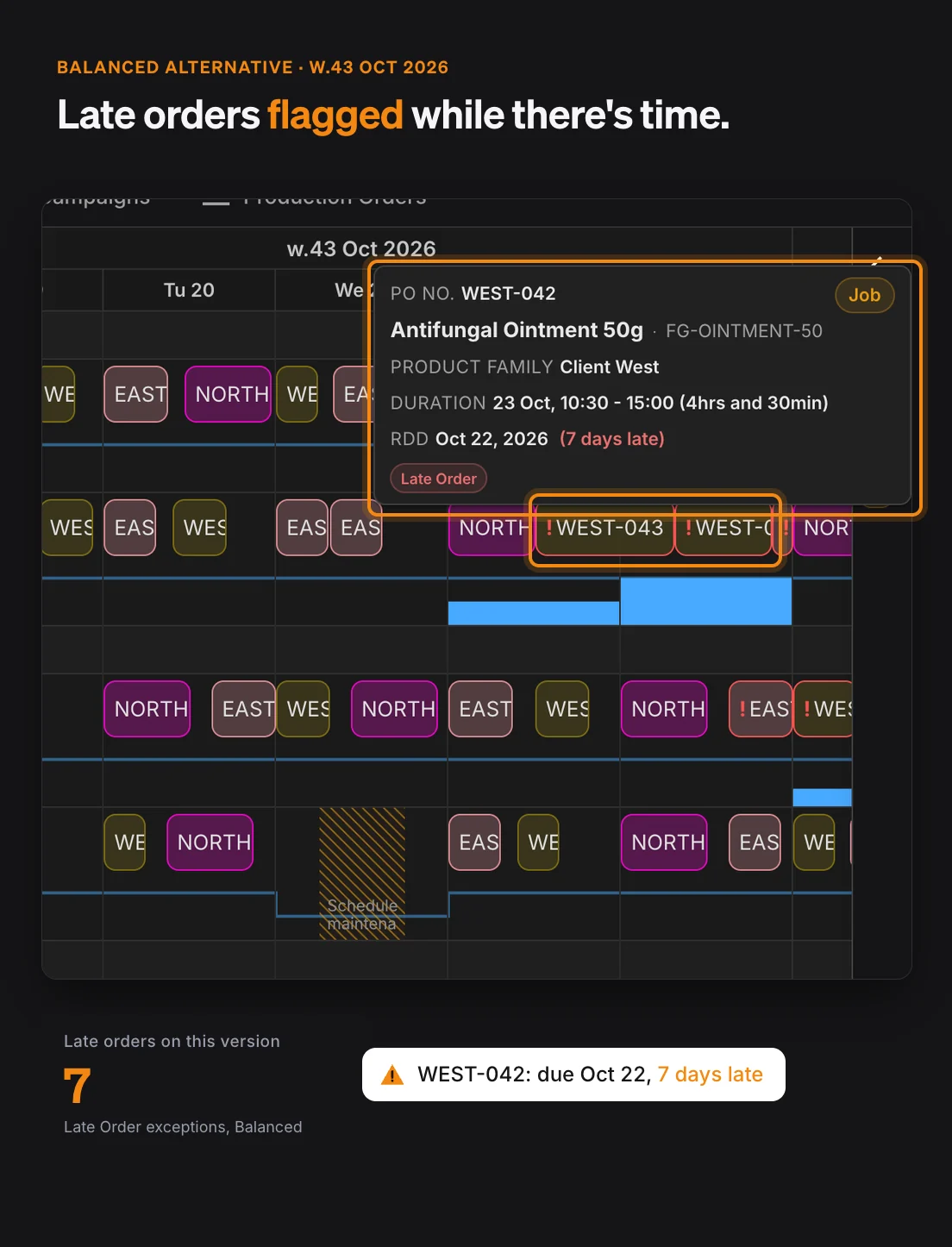

PLAIO checks each schedule version for late orders and overlapping jobs. It also catches broken wait times, missing changeovers and material that isn't ready. You see which delivery is at risk while there is still time to do something about it.
Clients judge you on on-time, in-full delivery. You protect it by seeing late orders while the week can still change.
